The Renovation & Addition Process in Charlotte, NC
A Charlotte renovation or addition typically moves through six stages: an initial consultation, site and zoning analysis, design refinement, builder selection, permit drawings, and construction. Most projects take six months in design before a shovel ever hits the ground, and each stage builds directly on the one before it.
Where Does It Actually Start?
It starts with a conversation, not a drawing. Before anything gets sketched, we need to understand what's actually not working in your current house and perhaps what pieces are missing. Not enough light in the kitchen? No real mudroom? A primary suite that feels like an afterthought? That conversation shapes everything that follows.
In our office, the first consultation is free and usually runs about 45 minutes. In that meeting we outline the process of design and construction but don’t get into many specifics on your project. The next step is a site visit, 1.5 to 2 hours, for $600. That one costs more because our architect is actually walking your existing structure, looking at what's load-bearing, what's not, and what your renovation is realistically up against. That $600 is credited to your overall fee if you proceed with the design.
We cover a lot in this first site meeting:
- Your goals for the project, in your own words
- What's not working in the current layout
- A rough process checklist and cost overview
- Who else needs to be on the team (builder, engineer, interior designer, surveyor)
- What construction will actually involve, start to finish
What Hapens Before Any Design Work Begins?

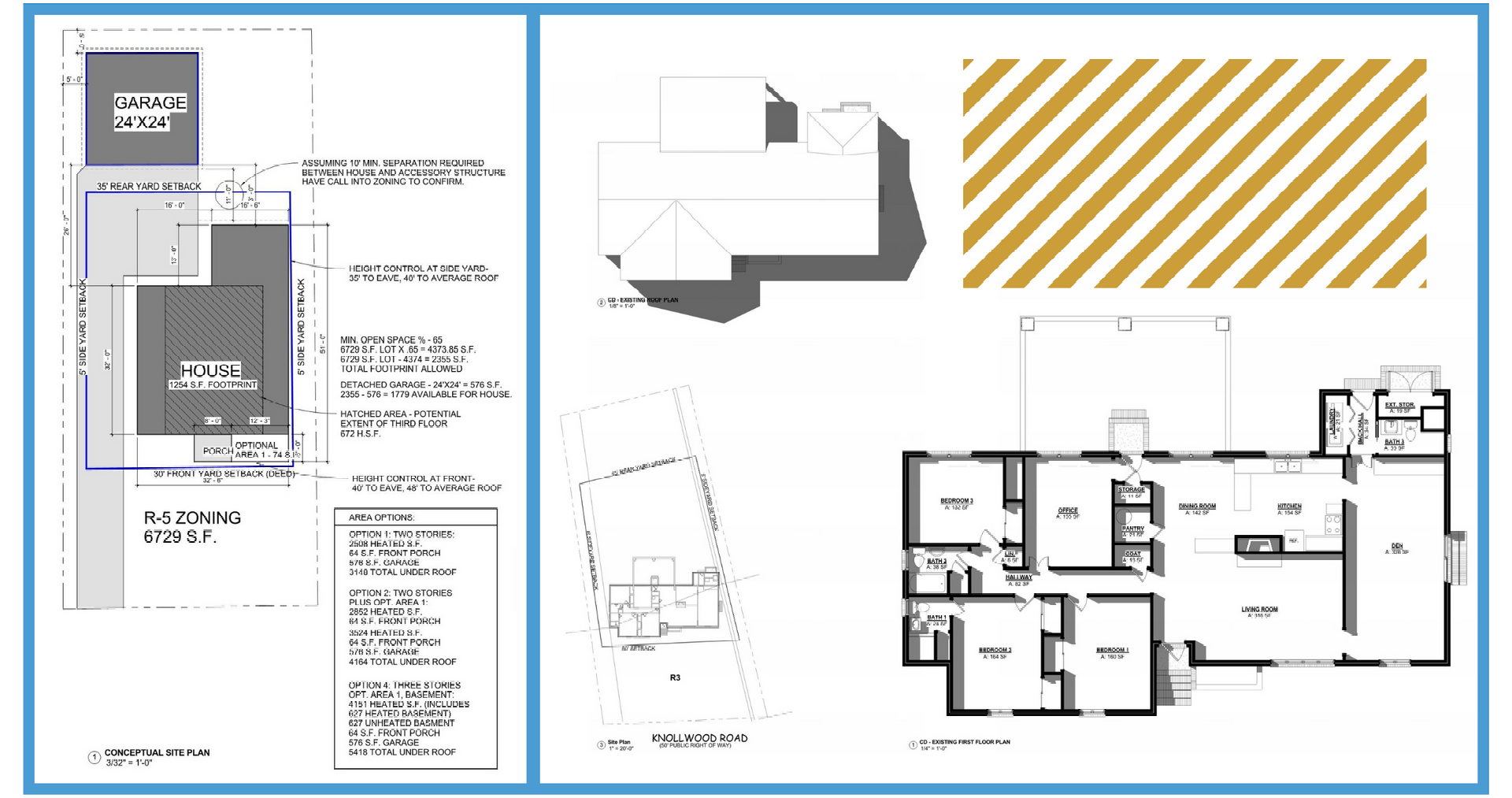

This is the step people don't expect, and it's arguably the one that matters most. Before we draw anything, we do the homework: a full site analysis, a zoning code review against Charlotte's Unified Development Ordinance, and a base plan showing your lot lines and existing landscape.
Skipping this step is how homeowners end up designing an addition their lot can't legally support. Setbacks, height limits, and lot coverage rules aren't optional, and finding out about them after you've fallen in love with a floor plan is a bad way to start a project.

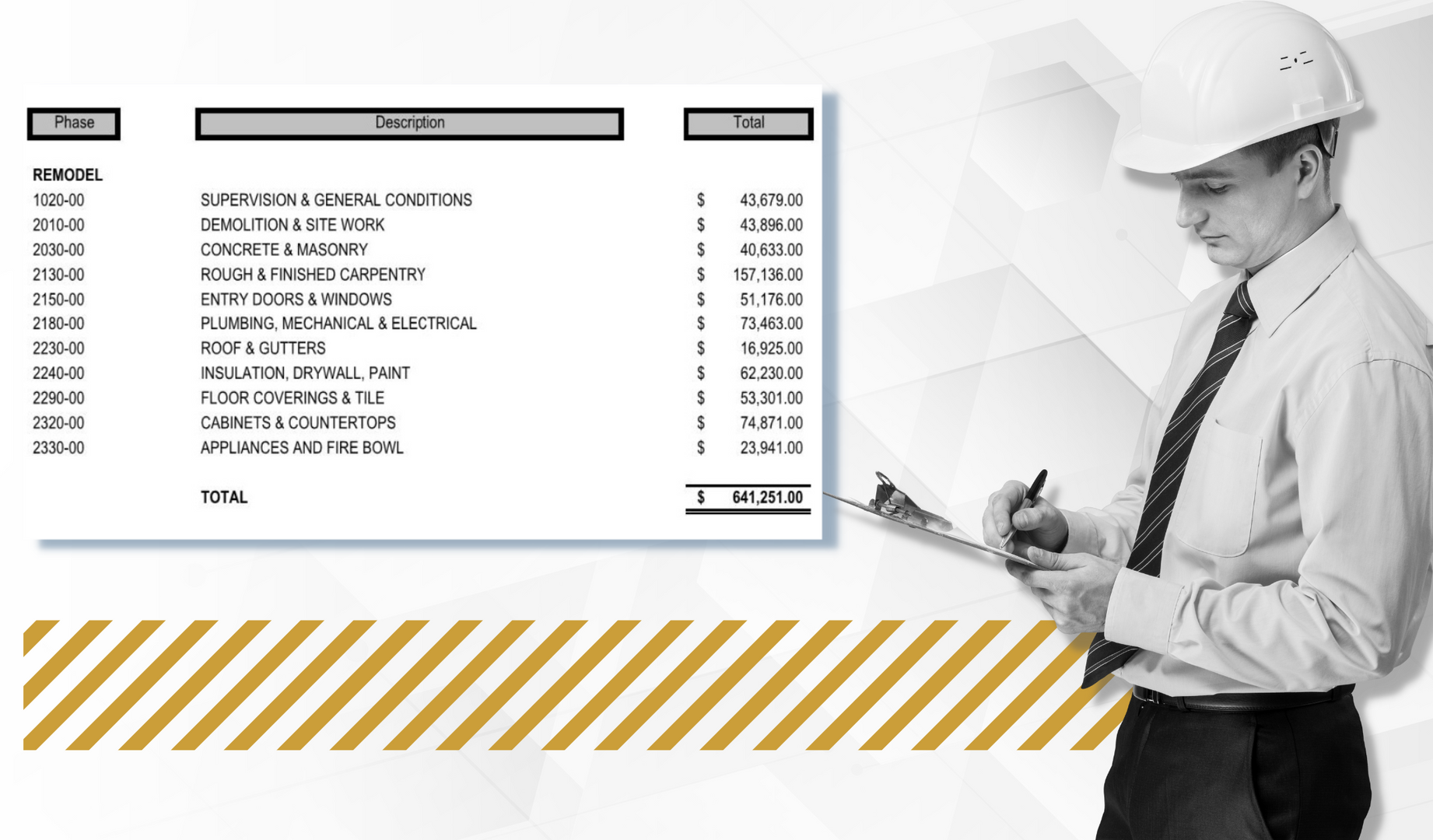

Once that groundwork is done, we bring you three options: small, medium, and large. Same core idea, three different levels of investment, so you can see what each one actually buys you before committing. This is also a good moment to loop in a builder for rough cost estimates on each version, which ties directly into how we recommend evaluating whether a renovation is worth the cost.
How Does a Rough Concept Become a Real Design?

Once you've picked a direction, we get specific. Detailed floor plans, 3D views, the kind of drawings where you can actually picture yourself standing in the new space instead of squinting at a diagram.
This is a back-and-forth phase, and it should be. If something feels off, say so now. It's much cheaper to change your mind about a window placement on paper than it is once framing is up. We'd rather have an honest, slightly awkward conversation in this phase than an expensive one during construction
How Do You Pick the Right Builder?

The design is only half the equation. The builder you choose determines whether that design actually gets executed the way it was drawn. We help with this part too, we have a network of contractors we trust in the Charlotte area, and we'll tell you honestly whether a builder you're considering is a good fit for our process. Ideally the builder is part of the team from the start. But that’s a subject for another day.
Before final design approval, we want any builder on the team to check a few boxes:
- Can give rough cost estimates early, not just after everything's finalized
- Is willing to work with us on design adjustments as they come up
- Can actually align with our schedule
- Has a track record of quality craftsmanship
- Knows local codes and permitting inside and out
One thing worth knowing: not all builders are interchangeable across project types. A contractor who's great at multi-family isn't necessarily the right fit for a luxury second-story addition or a detached pool house. Ask about specific past projects, not just years in business.
What Should You Be Doing While We Handle Permitting?

Behind the scenes, we're preparing and submitting your permit drawings and responding to whatever Mecklenburg County asks for. That part's on us, and it's genuinely why you hired an architect and a builder in the first place, you shouldn't have to think about it.
What's actually worth your attention during this window is everything on your side of the fence, because this is the last stretch where changes are still cheap. Once the permit is submitted, the design is essentially locked. Changing your mind after that costs real time and real money.
So while permitting is moving along, this is the window to:
- Give the drawing set one last real look. Not a skim, an actual walk-through. This is your last free chance to catch something before it's locked in.
- Finish making finish and material selections. Flooring, cabinetry, fixtures, tile. If you wait until construction starts to pick these, you risk holding up your own builder.
- Get clear on your contingency budget. Decide now what you'll do if something unexpected turns up mid-construction, not in the middle of a stressful moment when it actually happens.
Think of this stage as the calm before before the storm. Permitting takes patience, but the choices you make (or put off) during it are part of what determines how smoothly construction actually feels once it starts.

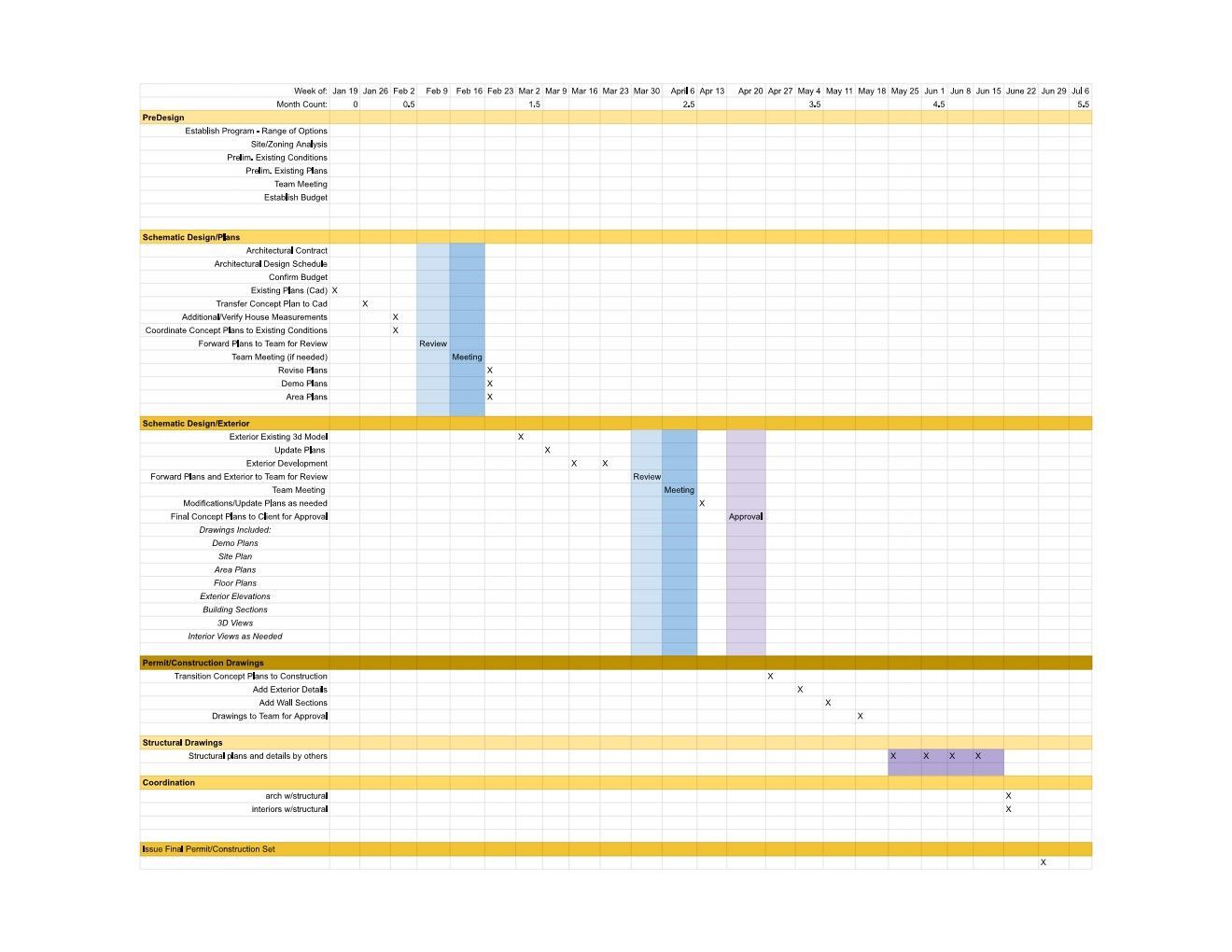

How Long Does All of This Actually Take

Design typically takes longer than most homeowners expect, often four to eight months depending on project complexity and how many rounds of revisions are needed. Permitting and final construction contracts add more time on top of that and it's largely out of anyone's direct control since it depends on the county's review queue. Construction timelines vary widely based on scope, but a well-planned and thoughtful design phase is what keeps the construction phase from running into surprises.
It should not go unsaid that clients themselves have a great deal of control and influence over the schedule. Clients will be faced with many decision points and while the architect, interior designer, and builder can provide data and guidance, at some point client decisions must be made. How long that takes, how busy the client is with work and family, can greatly influence the overall timeline, and are out of the control of the construction professionals.
| Stage | What Happens | Typical Length | Cost |
|---|---|---|---|
| 1. Consultation | Discuss goals, pain points, rough process and cost overview | 45 min (office) / 1.5-2 hrs (in-home) | Free (office) / $600 (in-home) |
| 2. Site & Zoning Analysis | Site analysis, UDO zoning review, base plan, 3 design options | 2-4 weeks | Included in design fee |
| 3. Design Refinement | Detailed floor plans, 3D views, revisions | 6-10 weeks | Included in design fee |
| 4. Builder Selection | Vet and select a builder, align on cost estimates | Runs parallel to design | Builder's estimate, no added fee |
| 5. Permit Drawings | Prepare and submit permit set, respond to city requests | 10-12 weeks | Included in design fee |
| 6. Construction | Builder executes; optional architect observation | 8 -14 months | Per builder contract |
The Bottom Line
A renovation or addition isn't one big decision, it's six smaller ones, made in sequence: understand the goals, study the site, refine the design, pick the right builder, get through permitting, then build. There is, of course, nuance and variation in these steps, but hopefully this helps you understand the basics.
If you're earlier in this process and still deciding whether your project makes financial sense in the first place, our guide to figuring out how much of your house to renovate is the right place to start before this one.
